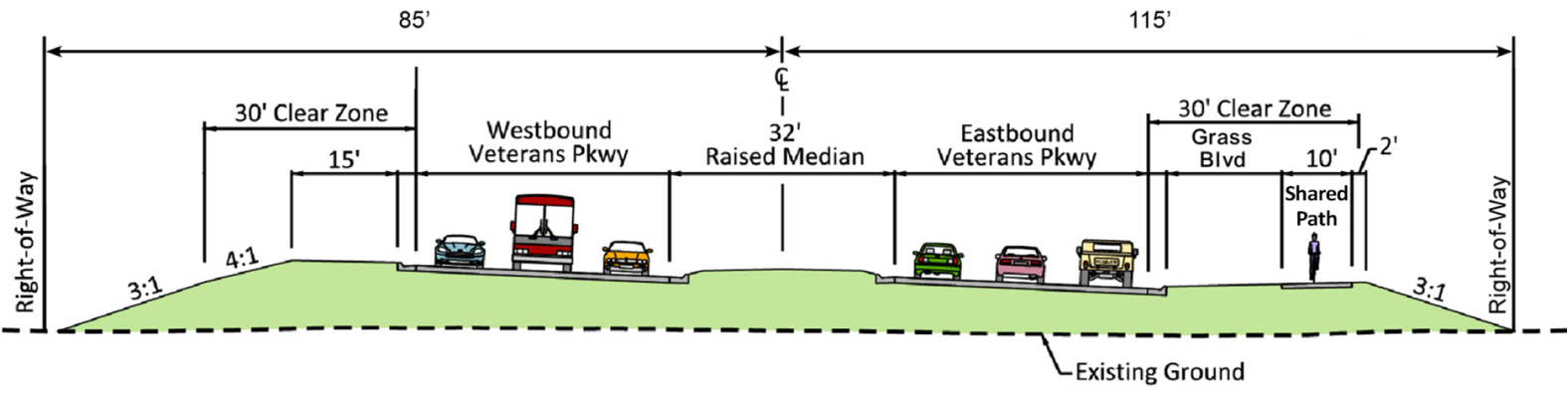

Veterans Parkway will be the same as the section constructed north of Arrowhead Parkway. In general, the new roadway will consist of:

  • Three lanes per direction
  • A 32-foot raised median separating the travel lanes
  • Shared use path along the south side of the Parkway
  • Grass boulevard separating the path from the roadway
  • Speed limit of 50 mph.
Rendering of construction plans

Current Construction

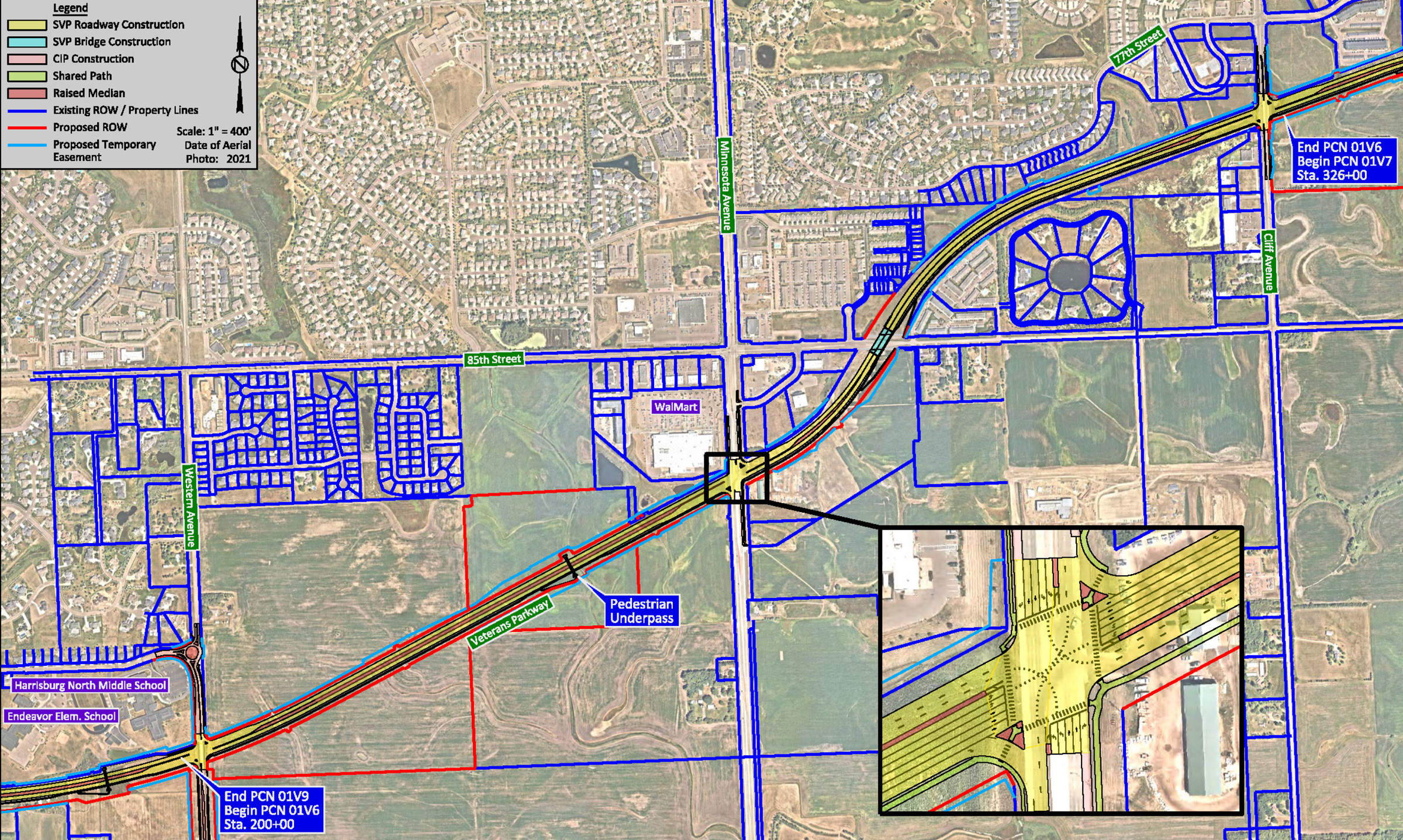

Cliff Avenue to Sycamore Avenue

Construction Timeline: 2025-2026

Components

  • Pedestrian underpasses will be installed between:
    • Cliff Avenue and Southeastern Avenue
    • Southeastern Avenue and Sycamore Avenue
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • Southeastern Avenue
    • Sycamore Avenue
  • An overpass will be installed at the BNSF railroad.

View Construction Details

Click to enlarge.
Project Timeline
  • April 2025 - Construction Begins
  • Spring to Fall 2025 - Dirt Work, Storm Sewer, and on South Veterans Parkway and Southeastern Avenue; Paving on Southeastern Avenue
  • Spring to Fall 2026 - Dirt Work and Utilities on Sycamore Avenue; Paving on South Veterans and Sycamore Avenue
  • Weather and Schedule Permitting

Design (Future Construction)

Note: Design for segments not under construction are not final and are subject to change.

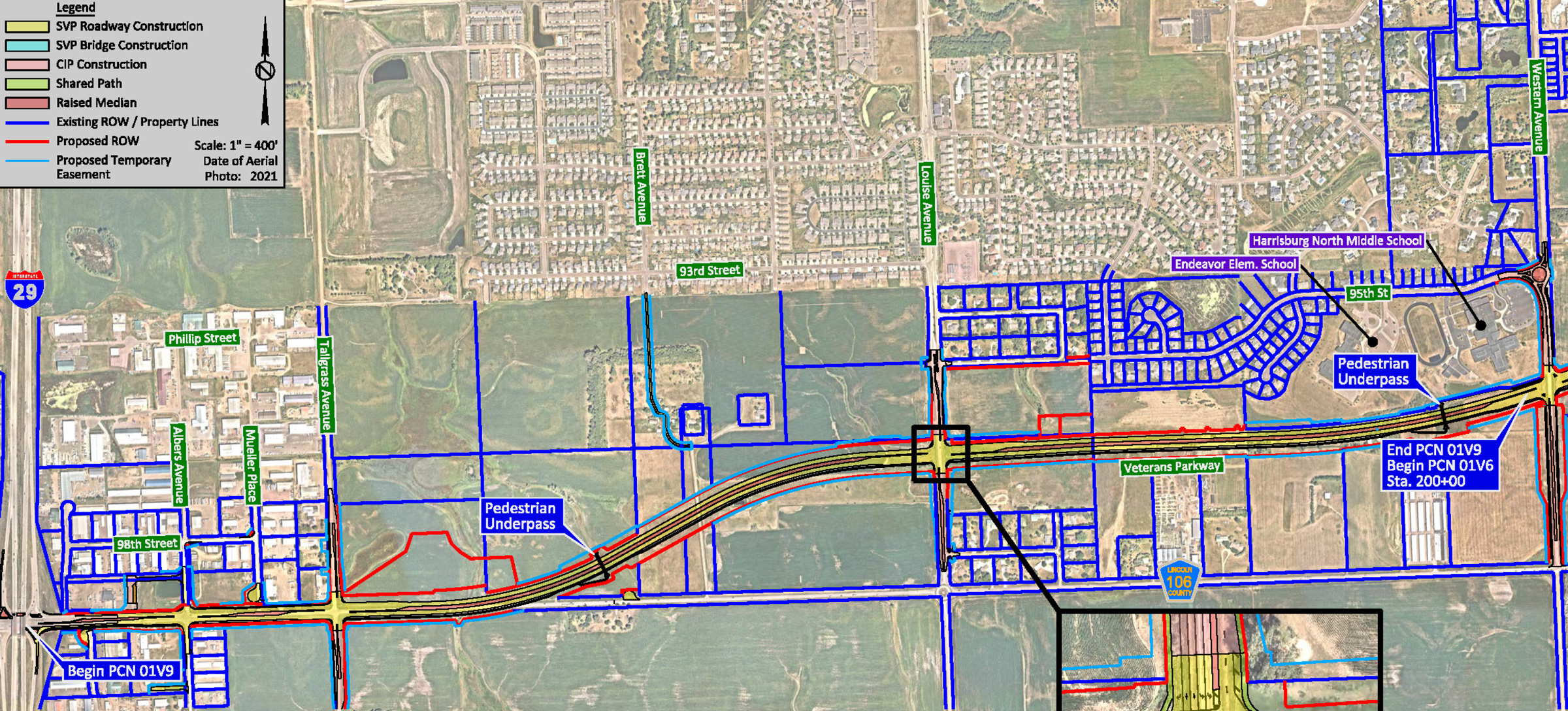

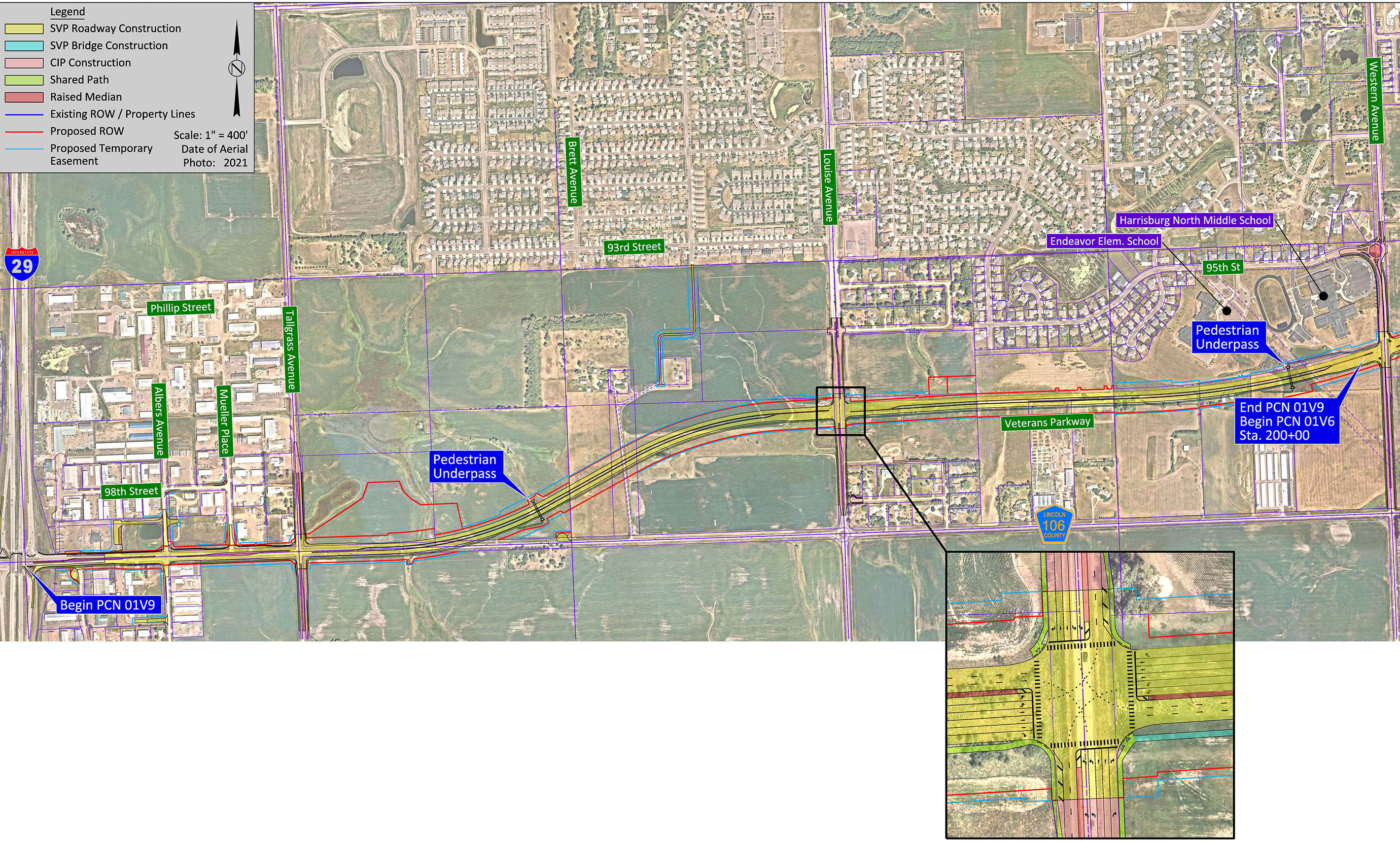

I-29 to Western Avenue

Design: Anticipated design complete in summer 2023.

Construction Timeline: Construction anticipated 2026 - 2027.

Components:

  • Pedestrian underpasses will be installed between:
    • Tallgrass Avenue and Louise Avenue
    • Louise Avenue and Western Avenue near Harrisburg schools
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • Albers Avenue
    • Tallgrass Avenue
    • Louise Avenue
Click to enlarge.

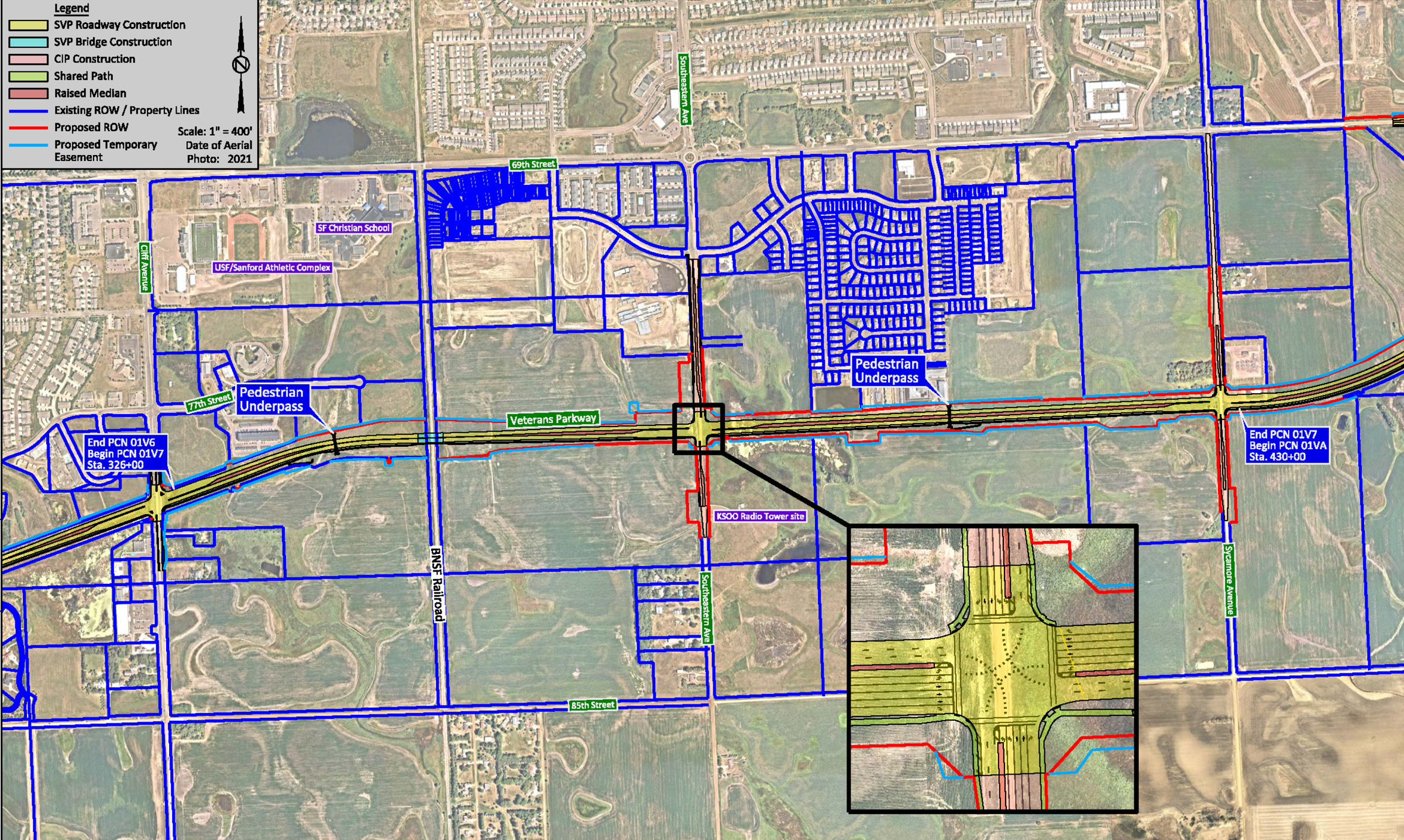

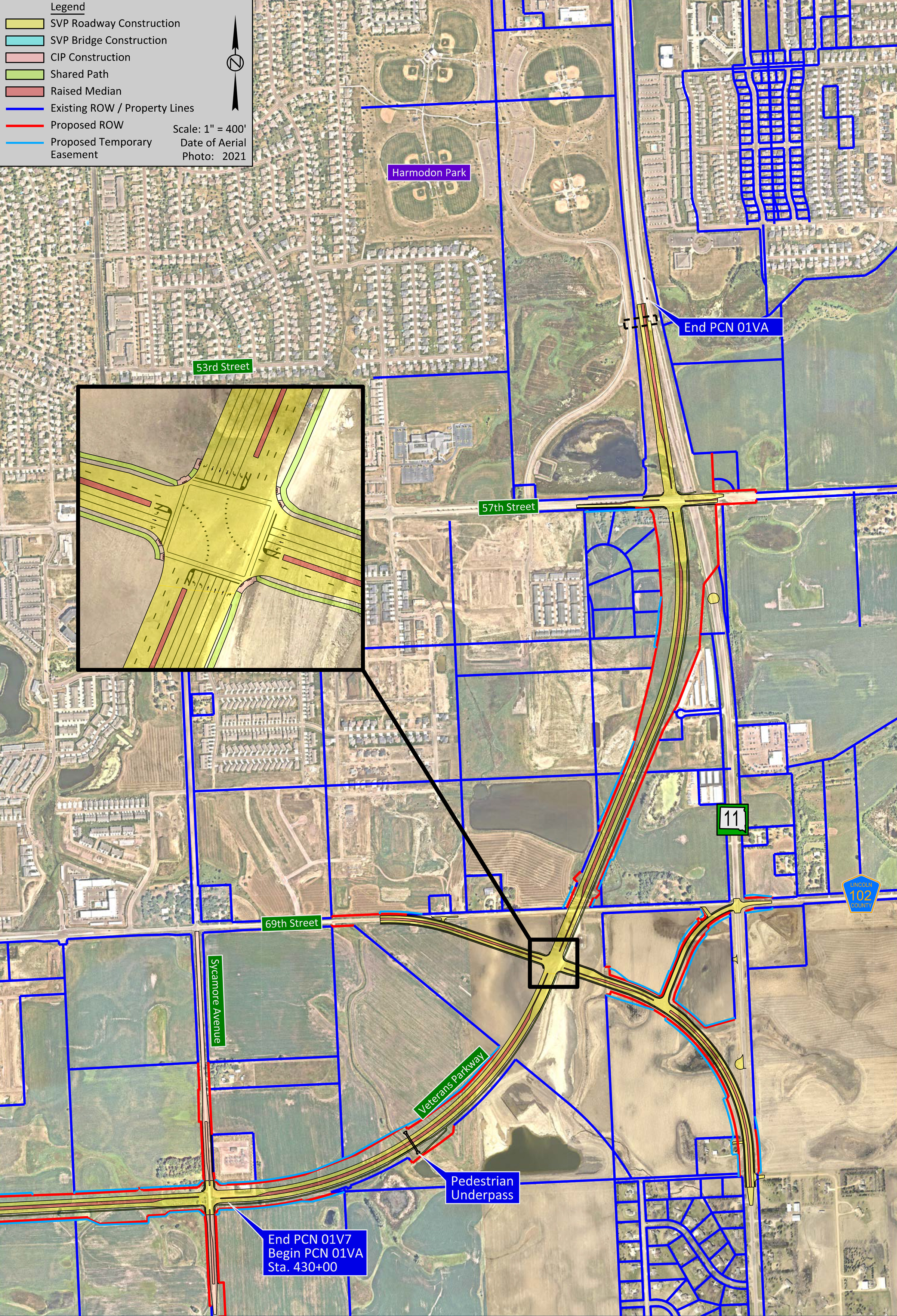

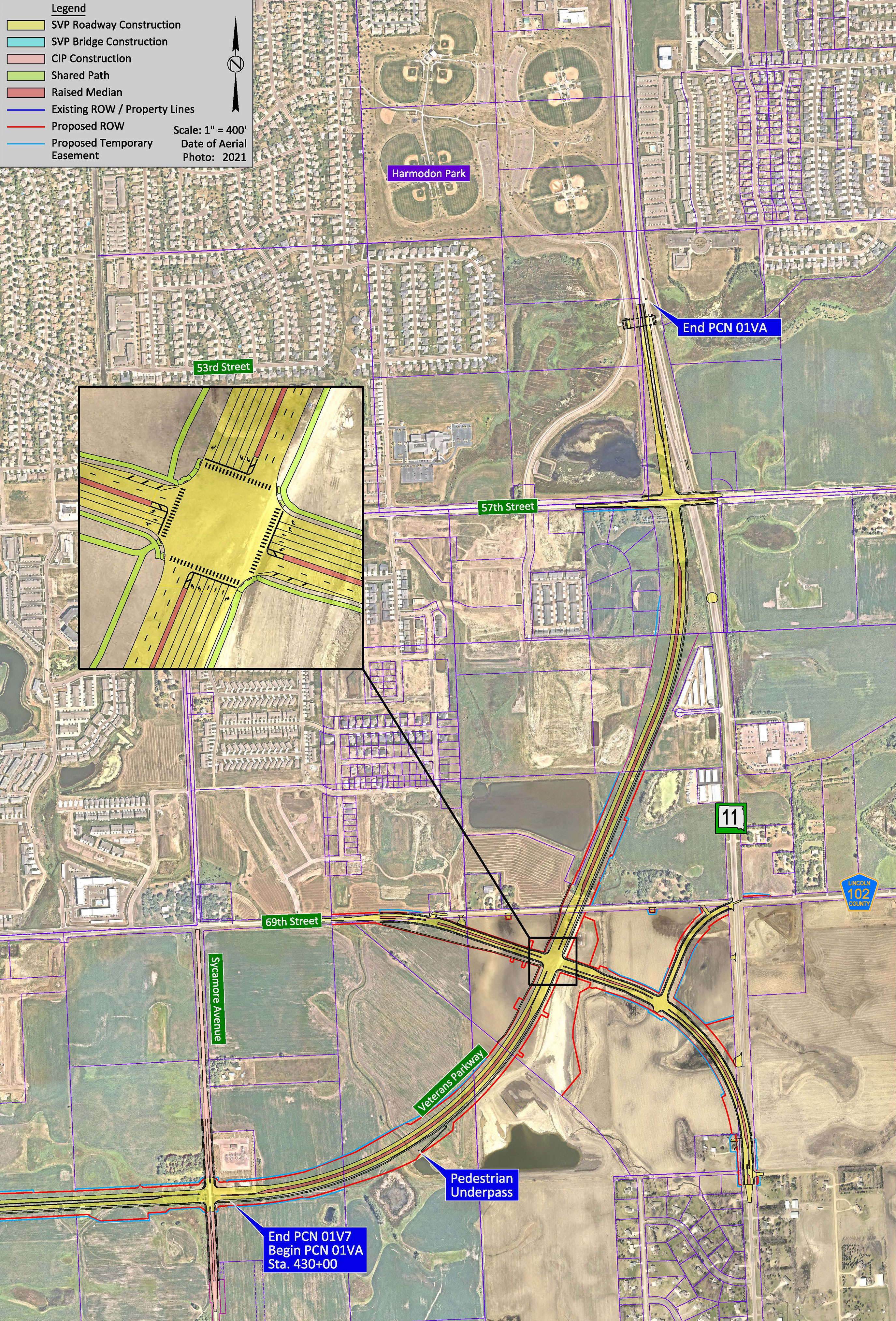

Sycamore Avenue to 57th Street

Design: Anticipated design complete in summer 2025.

Construction Timeline: Construction anticipated 2026 - 2027.

Components:

  • Pedestrian underpasses will be installed between:
    • Sycamore Avenue and 69th Street
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • 69th Street
    • 57th Street
  • Rehabilitation of the pedestrian underpass to Harmodon Park. See Harmodon Park Map Detour here.
Click image to enlarge

Completed Construction

Western Avenue to Cliff Avenue

Components

  • A pedestrian underpass was installed west of Minnesota Avenue.
  • Traffic signals at Western Avenue, Minnesota Avenue, and Cliff Avenue are compliant with the Americans with Disabilities Act (ADA).

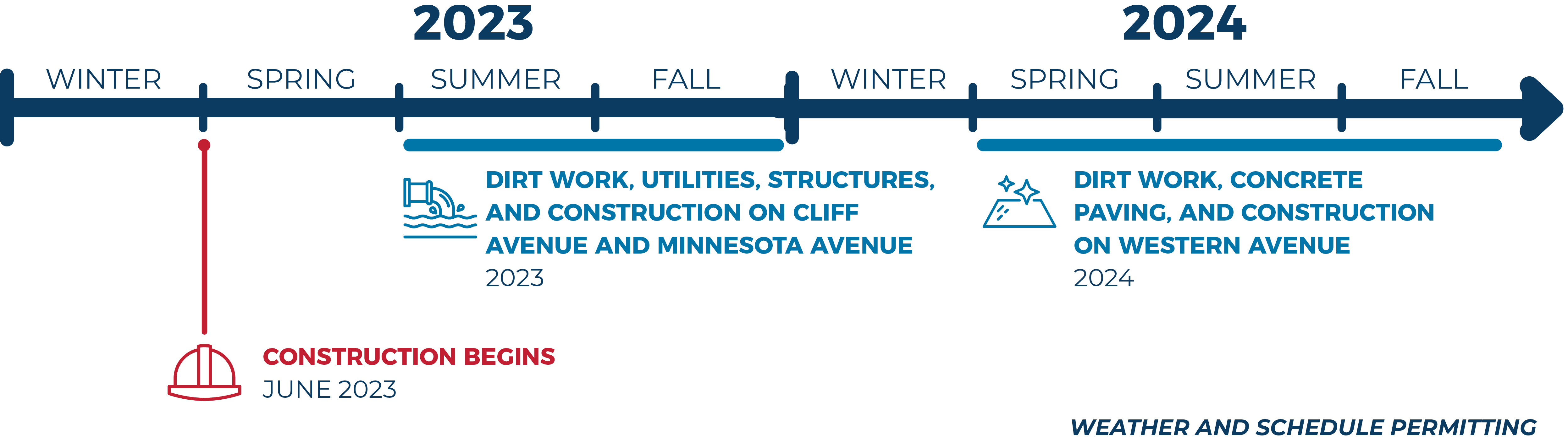

  • Construction Begins spring 2023
  • Dirt Work, Utilities and road work on Cliff Avenue during spring 2023
  • Road Work from winter 2023 through the fall 2024

Construction Quick Facts: Western Avenue to Cliff Avenue

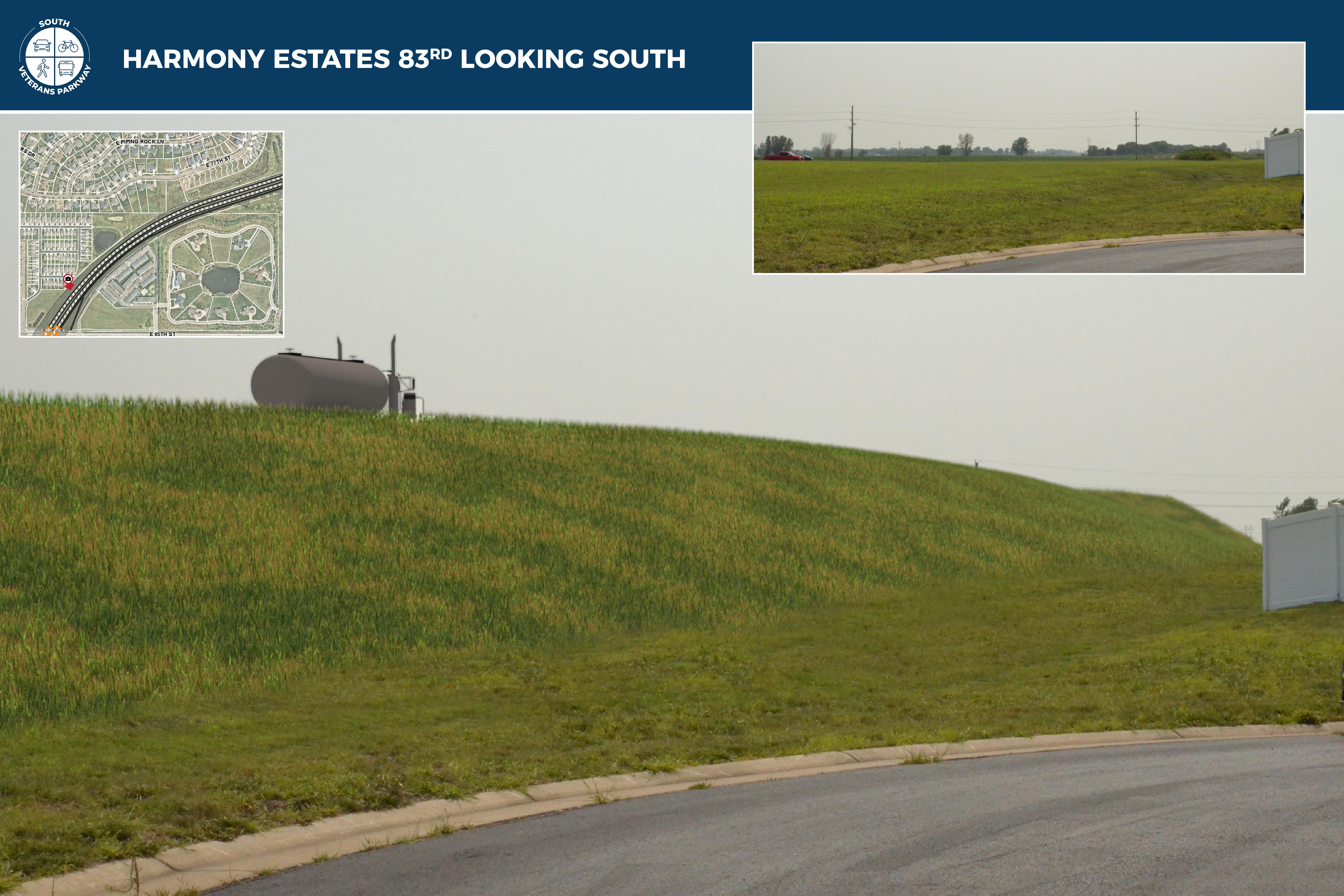

Click to enlarge.

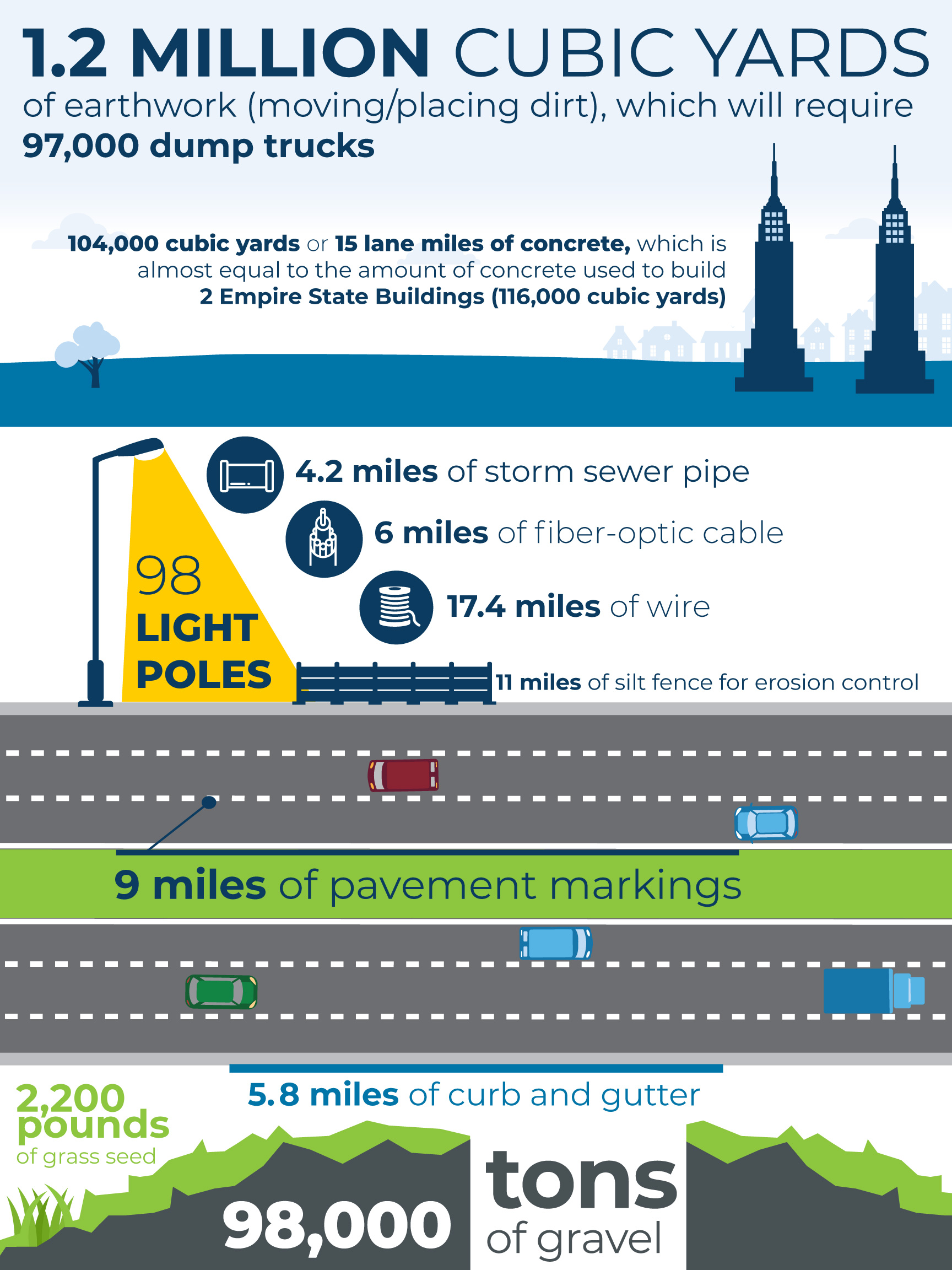

  • 1.2 million cubic yard of earthwork (moving and placing dirt), which will require 97,000 dump trucks
  • 104,000 cubic yards or 15 lane miles of concrete, which is almost equal to the amount of concrete used to build 2 Empire State Buildings (116,000 cubic yards)
  • 98 light poles
  • 4.2 miles of storm sewer pipe
  • 6 miles of fiber-optic cable
  • 17.4 miles of wire
  • 11 miles of silt fence for erosion control
  • 9 miles of pavement markings
  • 2,200 pounds of grass seed
  • 5.8 miles of curb and gutter
  • 98,000 tons of gravel
